Rehab Budget Checklist for Investors: Line-Item SOW Guide

Master your rehab projects with our comprehensive budget checklist. Cover all costs to secure the best returns on your investments.

Hand checking rehab budget checklist

Rehab Budget Checklist for Investors: Line-Item SOW Guide

Hand checking rehab budget checklist

Use a trade-aligned line-item rehab budget that covers four cost buckets, hard, hidden or structural, soft, and carrying, backed by a contingency percentage sized to the property’s condition and age and at least three contractor bids before you close. That’s the whole verdict. Everything else in this article is the how.

Your immediate next move, before you touch a spreadsheet template: build a scope of work organized by trade, with quantities and units attached to every line. “Repaint interior” is not a budget line. “1,850 square feet of drywall, prime and two coats” is.

Before you finalize any number for a lender or a partner, confirm you’ve accounted for:

  • All four cost buckets, not just materials and labor
  • A contingency percentage sized to the property’s condition and age
  • Three comparable bids on every major trade
  • Permit, holding, and financing costs baked into the total, not bolted on later

Key Takeaways

A defensible rehab budget combines four cost buckets, tiered contingency, three contractor bids, and draw-mapped tracking to survive lender review and real-world surprises.

Point Details
Cover four cost buckets Include hard, hidden/structural, soft, and carrying costs in every total, not just construction.
Set contingency by tier Budget 10% for cosmetic work, 10 to 15% for moderate rehab, and 15 to 25% for gut renovations.
Get three bids per trade Compare unit costs line by line, not just bottom-line totals, before hiring any contractor.
Map budget to draws Tie each line item to a milestone with photo and invoice evidence for lender releases.
Screen fast, confirm carefully Use Dealanalyzerai’s AI rehab estimator to tighten a screening number before finalizing your line-item budget.

Table of Contents

Why a Rehab Budget Checklist Matters for Investors

A square-foot screening number gets you through deal triage fast. It should never be the number you take to a lender. Screening ranges, roughly $25 to $40 per square foot for cosmetic work, $50 to $75 for moderate renovations, and $90 to $135 or more for gut rehabs, exist to help you decide whether a property is worth a second look. A line-item budget is what actually gets funded.

That gap between screening and funding comes down to four cost buckets every complete rehab budget needs:

  1. Hard costs. The physical construction: demo, framing, plumbing, electrical, finishes.
  2. Hidden or structural costs. Foundation issues, rot, outdated wiring behind walls, anything an inspection didn’t fully expose.
  3. Soft costs. Permits, plans, engineering, inspections, insurance.
  4. Carrying costs. Loan interest, property taxes, utilities, insurance during the hold.

Lenders expect scopes of work organized by trade, with quantities attached and numbers you can defend line by line. A vague “$40,000 for renovations” estimate gets kicked back. A budget that lists 12 window units at $650 each with a named supplier gets approved.

Pre-Rehab Planning: From Inspection to Fundable Bid

The sequence matters more than most investors realize. Skip a step here and you’ll be revising your budget mid-project, which is where most overruns start.

Start with a targeted inspection. You don’t need to inspect everything with equal intensity, but certain systems change your numbers dramatically if they’re wrong: roof condition and remaining life, foundation cracks or settling, HVAC age and capacity, electrical panel amperage, and plumbing material (galvanized pipe versus PEX changes your budget by thousands). EPA guidance on hazard screening also flags lead paint, asbestos, and mold as items that require licensed abatement, not a line item you estimate casually.

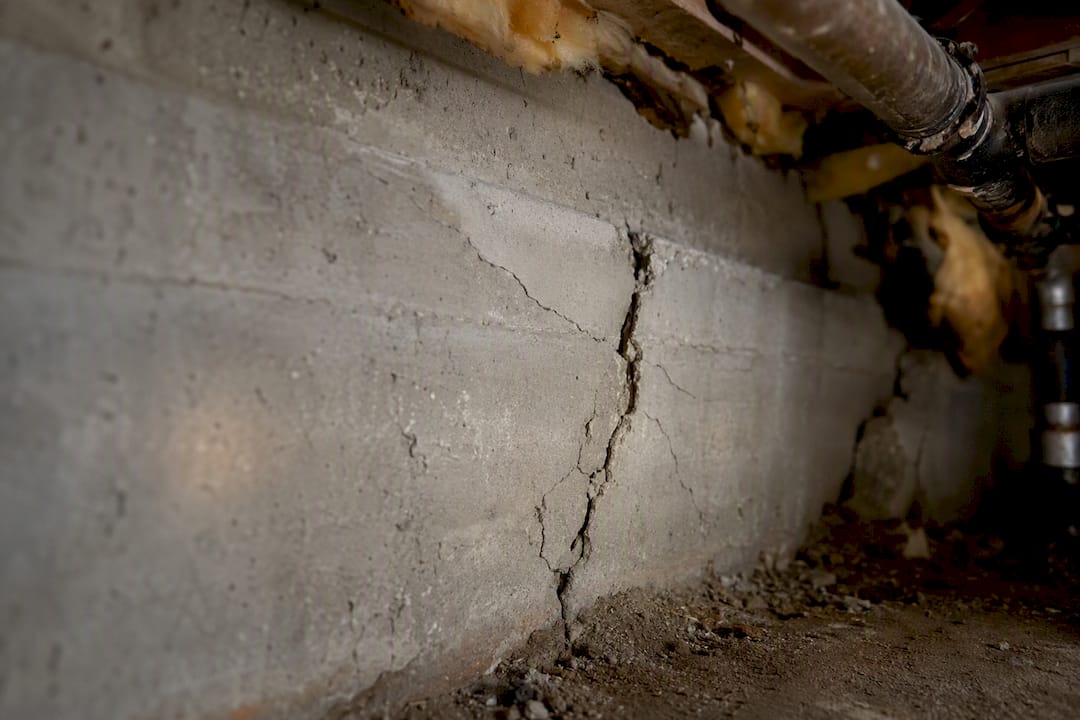

Cracked foundation wall detail

Write the scope of work by trade. Every line needs a quantity and a unit: linear feet of baseboard, square feet of flooring, count of light fixtures. This structure is what separates a rehab cost estimate an experienced investor can defend from a guess a contractor can inflate.

Collect multiple bids on every major trade. Compare unit costs, not just bottom-line totals. One contractor’s $8,000 kitchen quote might exclude appliance installation while another’s $9,500 quote includes it. Reading bids line by line is the only way to catch that before it becomes a change order.

  • Confirm each bid lists materials, labor, and disposal separately
  • Ask every contractor to quote against the same written scope
  • Flag any bid that’s dramatically lower than the other two before you get excited about it

Pro Tip: Use a fixed checklist template with every possible line item listed, even ones you expect to be zero for this project. Forcing yourself to write “$0, not applicable” next to a line is what catches the item you’d otherwise forget entirely.

The Complete Line-Item Rehab Budget Checklist

This is the actual punch list for rehab budgeting, organized the way a contractor’s scope of work should be organized: by trade, with the estimation hints that keep numbers honest.

Demolition and site prep

  • Interior demo (per square foot, debris hauling included or separate)
  • Dumpster rental (size and number of pulls)
  • Temporary utilities and site fencing if occupied or vacant-hold risk exists

Structural and framing

  • Foundation repair (requires a specialist quote, never a general contractor guess)
  • Sistering or replacing joists (per linear foot)
  • Load-bearing wall modifications (engineering stamp required in most jurisdictions)

Plumbing

  • Repipe (per fixture or whole-house lump sum)
  • Water heater replacement
  • Sewer line scope and repair if the inspection flagged root intrusion

Electrical

  • Panel upgrade (amperage matters, 100 amp to 200 amp is a common and pricey jump)
  • Rewire (per square foot or per outlet/switch count)
  • Fixture and outlet installation count

HVAC

  • System replacement (tonnage sized to square footage)
  • Ductwork repair or replacement (linear feet)
  • Thermostat and vent covers

Drywall, paint, and trim

  • Drywall material and labor (per square foot, patch versus full replacement)
  • Interior paint (square footage, number of coats)
  • Trim, baseboard, and door casing (linear feet)

Flooring

  • Material cost per square foot by room (LVP, tile, carpet, hardwood refinish)
  • Installation labor, often quoted separately from material
  • Subfloor repair if water damage was found

Kitchens and baths

  • Cabinets (linear feet or per-box pricing)
  • Countertops (per square foot, material grade matters enormously)
  • Plumbing fixtures, tile, and vanity installation

Exterior and landscaping

  • Roof (per square, material grade)
  • Siding or exterior paint (square footage)
  • Landscaping, grading, and driveway repair

General conditions

  • Dumpsters, portable toilets, temporary power
  • Project management or general contractor fee (typically a percentage of the total)
  • Cleanup and final punch labor

Flag anything touching structural elements, mold, or suspected asbestos for a specialist quote before you finalize your total. These are the line items that blow up budgets when investors estimate them like a paint job. Document your unit rates as you go (cost per square foot of flooring, cost per linear foot of framing) so your next rehab budget template starts from real numbers instead of guesswork.

How Much Contingency Should You Budget for Rehab?

Contingency isn’t padding. It’s the buffer that keeps a discovered plumbing leak from turning into a blown budget and a difficult conversation with your lender. Practitioner consensus sets contingency in tiers tied to project scope:

  1. Cosmetic rehab (paint, flooring, fixtures): around 10% of hard costs
  2. Light to moderate rehab (kitchens, baths, some systems work): 10% to 15%
  3. Major or gut rehab (structural, full systems replacement): 15% to 25%

Adjust upward, sometimes toward the top of the range or beyond it, when the property was built before 1960, when you’re working with a contractor you haven’t used before, or when your pre-purchase inspection was limited (lockbox access only, no utilities on). This is a key factor in understanding how property condition affects rent price for landlords. Properties in flood zones or areas with known structural risk deserve the same conservative treatment.

Statistic to remember: a gut rehab with a a top-tier contingency on a substantial hard-cost budget means setting aside a significant reserve specifically for the unknown. That’s not overcautious. That’s the difference between a manageable surprise and a stalled project.

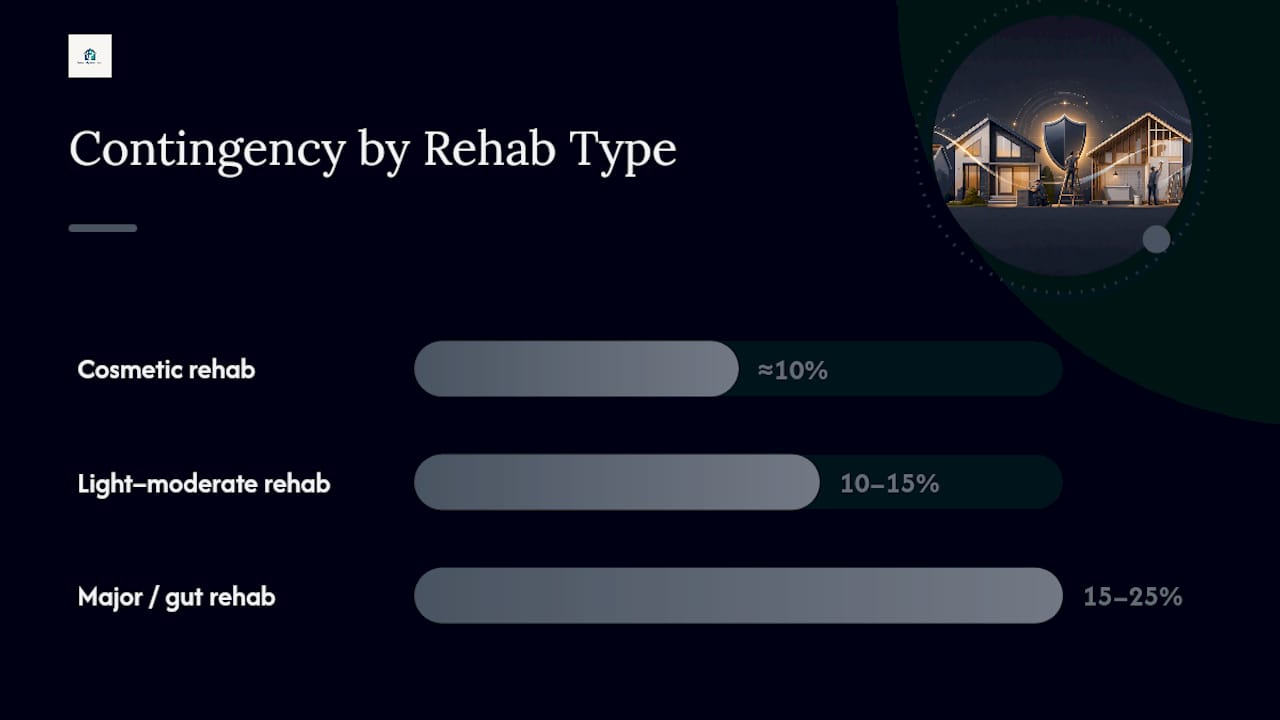

How Much Contingency Should You Budget for Rehab? — overview diagram

Contingency should only be released through a documented change order, never as a slush fund a contractor draws against informally.

Soft costs get overlooked constantly, and they’re the fastest way to blow a budget before construction even starts:

  • permit fees, which vary by jurisdiction and scope
  • Architectural plans or engineering stamps
  • Inspection fees (pre-purchase and progress inspections)
  • Dumpster and portable sanitation rental
  • Builder’s risk insurance
  • Loan origination and draw fees

Carrying costs deserve their own line of math. A simple rule of thumb: estimate your total holding cost as loan interest, property taxes, insurance, and utilities multiplied by your expected number of months to complete and sell or refinance. If your hard money loan runs 10% annually on a $200,000 draw and you expect a 5-month rehab, that’s roughly $8,300 in interest alone, before taxes, insurance, and utilities. Underestimating your timeline by even one month on a project like this adds real dollars you didn’t budget for.

Managing Contractors and Tracking Budget vs. Actual

The budget you build before day one is only useful if you track against it every week. This is where most rehabs go sideways, not in the estimating, but in the monitoring.

Set an approval threshold before work starts. Anything under, say, $500 in scope change might get a verbal go-ahead. Anything above it requires a written change order that specifies the cost, the reason, and which contingency line it draws from. Underwriters favor budgets that map every line item to a verifiable milestone, so group your line items into draw stages: demo and rough-in, mechanicals, drywall and paint, finishes and punch.

Each draw request needs evidence: dated photos of completed work, paid invoices, and a signed contractor statement. Lenders won’t release funds on a promise.

Your tracking sheet needs four columns, not more: budget, committed (what you’ve contracted for), paid (what’s actually left your account), and variance. Review it weekly during active construction, not monthly. A variance you catch in week two is a conversation. A variance you catch in week eight is a crisis.

  • Review committed vs. paid every Friday, no exceptions
  • Require photo documentation before releasing any draw
  • Keep a running log of every change order, even small ones

A one-second visual scan tells you where to focus before you dig into the details.*

Final Accounting and Lessons for Your Next Rehab

Closeout is where budgets get graded, and where most investors skip the paperwork that would make their next estimate better.

Walk the property with your contractor and build a punch list of unfinished or substandard items. Tie the final draw release, and any holdback you negotiated, directly to punch list completion. Don’t release the last payment until the list is clear or you’ve agreed on a specific credit for anything outstanding.

Reconcile your actual spending against the original budget, line by line, not just at the bottom-line total. Note where you used contingency and why. That pattern tells you something about how you’re inspecting properties before purchase.

Keep a lessons-learned log with a few fixed fields: line item, budgeted amount, actual amount, variance reason, and a note on whether your estimating method needs adjusting. Over five or six rehabs, this log becomes more valuable than any generic renovation planning guide, because it’s built from your own numbers, your own contractors, your own market.

A Practical Note From Sam

The most common budget mistake I see isn’t bad math, it’s omission. Investors nail the hard costs and forget soft costs and contingency entirely, then wonder why their spreadsheet and their closing statement don’t match.

My shortcut: build one master line-item template with every trade and every soft-cost category pre-listed, then force a number, even zero, into every row before you call it done. It’s tedious the first time. By your third rehab, it takes fifteen minutes and catches things you’d have missed cold.

Use the checklist here as your starting template, and let the fix and flip calculator check your math against total project economics before you commit to an offer.

Where DealAnalyzerAI Fits Into Your Rehab Workflow

Building a fundable line-item budget from scratch takes hours most investors don’t have when they’re screening several properties a week. Dealanalyzerai gives you a faster starting point: upload property photos and the AI rehab estimator generates cost estimates by comparing them against renovation data and comparable sales, alongside ARV ranges and a maximum allowable offer calculation.

Dealanalyzerai

That output isn’t a replacement for the three contractor bids this checklist calls for. Think of it as the screening step done right, tighter than a flat per-square-foot guess, fast enough to run on every property you’re evaluating this week. You still write the trade-by-trade scope of work, still collect real bids, still set your contingency by tier. Dealanalyzerai just gets you to that starting number faster and flags risk before you write an offer. Try the free rehab cost estimator on your next property and see how the AI-generated range compares to your own line-item build.

Sources

This checklist draws on more than internal opinion. The core recommendations line up with what regulators and lending practitioners actually require:

Across every credible source on this topic, the consensus is remarkably consistent: line-item budgets beat lump-sum guesses, three bids beat one, contingency should scale with project risk, and every dollar should tie to a draw milestone a lender can verify.

Investors who treat contingency as a formal, documented reserve, rather than a mental cushion, are the ones who get funded faster and argue with their lender less.

An AI-assisted rehab cost estimator can accelerate the screening step by analyzing property photos and comparable renovation costs before you ever call a contractor. It’s a starting point for your line-item budget, not a substitute for the three bids you still need.

FAQ

How Do You Calculate Rehab Costs?

Start with a per-square-foot screening range to triage the deal, then build a trade-by-trade line-item budget with real quantities, confirmed by at least three contractor bids, before you finalize a number.

What Is a Rehab Budget?

A rehab budget is a complete cost plan covering four buckets: hard construction costs, hidden or structural surprises, soft costs like permits and inspections, and carrying costs like loan interest during the hold period.

What Should a House Refurbishment Checklist Include?

It needs line items by trade (demo, framing, plumbing, electrical, HVAC, finishes), a contingency percentage sized to the project’s scope, soft costs like permits and insurance, and carrying costs for the full hold period.

What Is a Realistic Renovation Budget?

Realistic renovation budgets vary widely by scope, roughly $25 to $40 per square foot for cosmetic updates, $50 to $75 for moderate work, and $90 to $135 or more for a gut rehab, but every number needs contractor bids and a contingency reserve before you treat it as final.

How Much Contingency Should I Budget for a Rehab?

Set contingency around 10% for cosmetic projects, 10 to 15% for moderate rehabs, and 15 to 25% for major or gut renovations, adjusting upward for older properties or limited pre-purchase inspections.
