Add 10–30% to Rehab Estimates: 2026 Rehab Cost Inflation for Investors
Labor driven rehab cost inflation in 2026 is shrinking investor profits. Learn when to reprice, when to add 10–30% contingency, and how photo based...

Add 10–30% to Rehab Estimates: 2026 Rehab Cost Inflation for Investors

The pressure is coming from labor, not materials, and it’s not slowing down. Two moves protect your margin right now: pad your contingency line to those levels, and refuse any bid older than 90 days without a fresh number attached.
TL;DR:
- Labor costs have increased by over 4% year over year, outpacing material price hikes, which can significantly reduce profit margins on rehab projects.
- Bids should be no older than 90 days for most scopes, and shorter timelines of 30 to 45 days are necessary for trades like electrical and HVAC to ensure cost accuracy.
- Tariff-driven price swings mainly affect lumber, cabinets, appliances, and copper components, often causing over 20% overruns in renovation budgets when overlooked.
- Building an inflation-adjusted rehab estimate involves setting higher contingency percentages and validating bids in writing to account for rapid cost changes.
- Using photo-based AI estimators can generate quick, reliable rehab cost ranges to improve deal screening and help stress-test maximum allowable offers more effectively.
Table of Contents
- How Rehab Cost Inflation Is Wrecking Your MAO Math
- How Do You Adjust Rehab Estimates for Inflation?
- What Data Should You Check Before Re-Pricing a Rehab Scope?
- Keeping Your Rehab Numbers Current Every Week
- Quick Guardrails to Copy Into Your Underwriting Template
- Why I’m More Conservative on Rehab Numbers Than I Used to Be
- Try DealAnalyzerAI’s Rehab Cost Estimator on Your Next Deal
- Sources
- FAQ
How Rehab Cost Inflation Is Wrecking Your MAO Math
Your maximum allowable offer only works if your rehab number holds. When it doesn’t, the whole underwriting stack shifts underneath you, and the damage compounds fast because MAO sits downstream of every other assumption in the deal.
Run the math on a simple flip. Say your ARV comes in at $300,000, your target profit is $50,000, and your original rehab estimate is $60,000. Your MAO lands around $190,000 after acquisition costs. Your MAO drops by the full $6,000 difference, and if you already offered based on the old number, that $6,000 comes straight out of your profit instead.
Labor is the driver behind that shift, not lumber or drywall. Verisk’s Q2 2026 reconstruction cost analysis found combined hourly billable labor rose 4.09% year over year against just 2.95% for materials. That gap matters because labor makes up the majority of most rehab budgets, so a smaller percentage increase on the bigger line item outweighs a larger jump on the smaller one.
A few other pressure points that rarely make it into a first-pass estimate:
- Permit turnaround times have stretched in many jurisdictions, adding carrying costs onto projects that used to move faster.
- Insurance premiums on renovation and builder’s risk policies have climbed alongside reconstruction costs, since insurers price those policies off the same cost indices.
- Trade availability varies sharply by region, and a scarce electrician or HVAC tech in your market can blow past national averages.
None of this shows up in a quick eyeball estimate. It shows up in the closeout invoice, usually after you’ve already made the offer.
How Do You Adjust Rehab Estimates for Inflation?
Building an inflation-adjusted number isn’t guesswork if you follow a consistent process every time you underwrite a property. Here’s the sequence that holds up across cosmetic flips and heavy gut jobs alike.

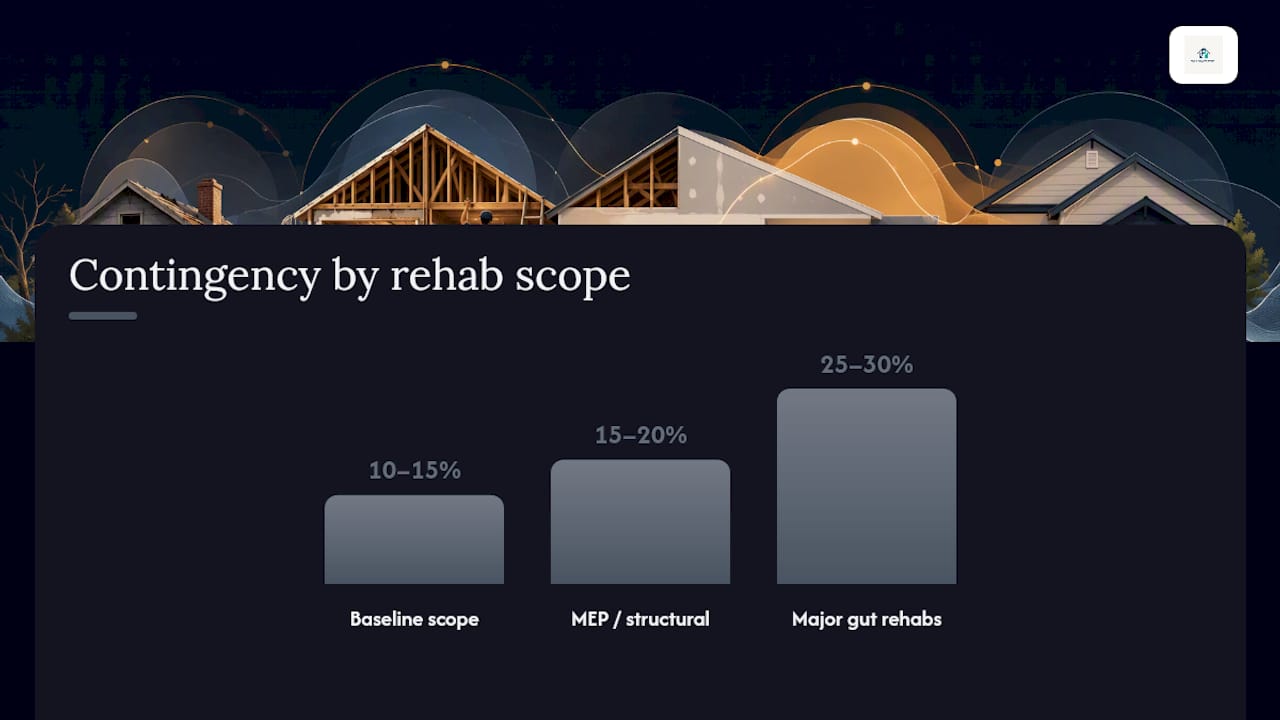

- Set your baseline contingency first. Start every scope at 10 to 15% above the contractor’s quoted number. Move to 15 to 20% for anything touching mechanical, electrical, plumbing, or structural systems, and go to 25 to 30% on major gut rehabs where multiple trades overlap and surprises compound.
- Validate every bid in writing. A verbal number from a contractor is not a number. Require a written bid with a stated expiration date and, where possible, a material price clause that protects you if lumber, copper, or appliance costs move before work starts.
- Run MAO and ARV sensitivity scenarios. Don’t underwrite to one number. Run your MAO at your quoted rehab cost, then again at 10% and 20% above it, and see how much cushion survives at each level before you commit to an offer.
- Lock procurement early on long-lead items. Cabinets, windows, and specialty appliances often carry the longest lead times and the most tariff exposure. Ordering early, or asking your general contractor for purchase-order price protection, removes one of the biggest swing variables in the whole budget.
Pro Tip: Ask every contractor for a bid date stamped on the document itself, not just a verbal “this is good for 30 days.” Bids without dates are the single easiest red flag to catch and the easiest one investors skip.
A full underwriting walkthrough that pairs these sensitivity runs with acquisition cost assumptions will tighten this even further, but the four steps above catch most of the damage on their own.

What Data Should You Check Before Re-Pricing a Rehab Scope?
Three sources will tell you almost everything you need before you touch a budget line: reconstruction cost indices, the Producer Price Index, and category-specific tariff reporting.
Verisk’s 360Value data showed residential reconstruction costs up 3.2% year over year through April 2026, which is a useful floor for how much a generic scope should move even before you account for regional labor pressure. The Producer Price Index is the earlier warning signal, since it tracks wholesale prices before they hit retail invoices. PPI for final demand rose 1.1% in May 2026 after a 1.4% jump in April, and back to back monthly increases like that are a signal to re-price active bids immediately rather than wait for your next scheduled review.
Watch these line items closely: copper wiring and plumbing, HVAC units and compressors, and major appliances have all shown outsized swings tied to recent tariff changes on imported components.
A field example from one 2026 fix-and-flip project shows what happens when nobody checks these numbers: an original $190,000 estimate closed out at $230,000, a 21% overrun driven mostly by material price moves during construction. That’s the cost of skipping the checklist.
Keeping Your Rehab Numbers Current Every Week
Cost of rehabilitation programs and materials shifts fast enough now that a number you trusted in January can be stale by March. Building a short weekly habit around it beats scrambling every time a deal lands on your desk.
Run through this each week before you screen new properties:
- Refresh your index check. Glance at the latest PPI release and any new Verisk data if it’s published that quarter.
- Re-pull active bids. Confirm nothing in your pipeline is running on a quote older than 90 days.
- Log contractor rate changes. Even a five-minute call with your go-to electrician or plumber tells you whether their rates moved.
- Re-run MAO scenarios on any deal still in negotiation using updated numbers.
This is where photo-based estimating tools earn their keep. Instead of waiting on a contractor walkthrough for every property you’re screening, an AI rehab cost estimator can analyze uploaded photos, flag likely scope items, and generate a cost range in minutes. DealAnalyzerAI’s rehab cost estimator builds this directly into the deal analysis workflow, cutting the guesswork out of a process that used to depend entirely on how many properties you could physically walk in a week.
For readers who want the line-item mechanics behind this, DealAnalyzerAI’s rehab estimating guide walks through the scope-by-scope detail this section only summarizes.

Quick Guardrails to Copy Into Your Underwriting Template
Keep these numbers within reach the next time you’re screening a property:
- Cosmetic rehab: 10% contingency, bids valid up to 90 days.
- Moderate rehab (kitchens, baths, some systems): 15% contingency, bids valid 45 to 60 days.
- Heavy rehab (structural, full mechanical/electrical/plumbing): 20 to 30% contingency, bids valid 30 to 45 days.
- High-pressure trades (electrical, HVAC, plumbing): treat any bid older than 30 to 45 days as expired and require a fresh quote.
- Price-protection clauses: insist on one whenever a scope includes tariff-exposed materials like cabinets, appliances, or specialty lumber.
Why I’m More Conservative on Rehab Numbers Than I Used to Be
The most common mistake I see right now is investors anchoring to a rehab number they got months ago and treating it as fixed. It isn’t. Labor costs and tariff-driven material swings move faster than most underwriting habits have caught up to, and the gap between “quoted” and “actual” is where deals quietly stop making money.
I spend most of my due diligence time on three things: reading the actual bid language for expiration dates and price clauses, calling trades directly instead of trusting a general contractor’s markup blind, and stress-testing MAO at more than one rehab number before I ever submit an offer. None of that is exciting work. It’s also the difference between a deal that pencils and one that eats your profit six weeks into construction. Protect the margin before you chase the deal, not after.
— Sam
Try DealAnalyzerAI’s Rehab Cost Estimator on Your Next Deal
Most investors are still pricing rehabs off a single contractor’s gut-feel number, then hoping it holds through closeout. DealAnalyzerAI replaces that guesswork with a photo-based estimator that reads your uploaded property photos, flags likely scope items, and returns a cost range in minutes instead of days spent waiting on a walkthrough.

Beyond the rehab number itself, the platform runs your ARV range, calculates your MAO, and stress-tests scenarios at multiple rehab cost levels, so you can see your cushion before you ever make an offer. That means faster, more consistent screening across every property on your list this week, not just the one you had time to walk in person.
Run a sample property through the free rehab cost estimator or start with the full deal analyzer to see your MAO and ARV output side by side before your next offer goes out.
Sources
Check these on a recurring basis: Verisk’s 360Value quarterly reconstruction cost analysis, PPI-driven cost pressure summaries, and tariff impact commentary on renovation budgets, plus a regional cost-checking example from Houston’s 2026 rehab cost guide.
- 360Value Q2 2026 Quarterly Reconstruction Cost Analysis
- Upstream inflation is not cooling: May 2026 PPI data signals more cost pressure ahead for rental investors | The Rental Edge
- Fix & Flip Rehab Costs in 2026: How Tariffs Are Squeezing Margins
FAQ
Is labor or materials driving rehab cost inflation right now?
Labor is the bigger factor. Verisk’s data shows combined billable labor up 4.09% year over year versus 2.95% for materials.
How old can a contractor bid be before I should distrust it?
Ninety days is the general limit for most scopes. For electrical, HVAC, and plumbing, treat anything older than 30 to 45 days as expired given how fast those trade rates are moving.
Which materials are most exposed to tariff-driven price swings?
Lumber, cabinets, appliances, and copper-based components have all shown the sharpest tariff-related cost increases in recent renovation budgets.
Can an AI tool actually estimate rehab costs accurately from photos?
Tools like DealAnalyzerAI’s rehab cost estimator analyze uploaded property photos to flag scope items and generate a cost range, cutting the time needed for manual walkthroughs on every property you screen.
